TABLE OF CONTENTS
Construction Activities undertaken during
the Reporting Month
Statues of Environmental Licensing and
Permitting
Monitoring Parameters, Frequency and
Duration
Monitoring Methodology and QA/QC Procedure
Monitoring Parameters, Frequency and
Duration
Monitoring Methodology and QA/QC Procedure
Implementation Status of Environmental
Mitigation Measures
Implementation Status of Event and Action
Plans
Summary of Complaint, Warning, Notification
of any Summons and Successful Prosecution
Monitoring Schedule for Next Month
lIST OF TABLES
Table I............... Summary
of Complaint/Summons/Prosecution in the Reporting Month
Table
1.1............ Key
Project Contacts
Table
1.2............ Summary
of Environmental Licensing and Permit Status
Table
2.1 ........... Locations
for Air Quality Monitoring
Table
2.2 ........... Air
Quality Monitoring Equipment
Table
2.3 ........... Impact
Dust Monitoring Parameters, Frequency and Duration
Table
3.1 ........... Noise
Monitoring Stations
Table
3.2 ........... Noise
Monitoring Equipment
Table
3.3 ........... Noise
Monitoring Parameters, Frequency and Duration
Table
3.4 ........... Baseline
Noise Level and Noise Limit Level for Monitoring Stations
Table
4.1............ Quantities
of Waste Generated from the Project
Table
6.1............ Observations
and Recommendations of Site Inspections
Table
6.2............ Status
of Required Submission under Environmental Permit
lIST OF FIGUREs
Figure 2 Project
Organisation for Environmental Monitoring and Audit

Figure 3 Location
of Monitoring Station
lIST OF APPENDIces
Appendix A Action and Limit Levels for Air Quality and Noise
Appendix B Copies of Calibration Certificates
Appendix C Weather Information
Appendix D Environmental Monitoring Schedules
Appendix E 1-hour TSP Monitoring Results and Graphical Presentations
Appendix F 24-hour TSP Monitoring Results and Graphical Presentations
Appendix G Noise Monitoring Results and Graphical Presentations
Appendix H Summary of Exceedance
Appendix J Environmental Mitigation Implementation Schedule (EMIS)
Appendix L Summary of Waste Generation and Disposal Records
Appendix M Construction Programme
Introduction
1. This is the 20th Monthly Environmental Monitoring and Audit (EM&A) Report prepared by the Environmental Team (ET), Cinotech Consultants Ltd., for Contract No. HY/2019/13 ¡§Central Kowloon Route ¡V Buildings, Electrical and Mechanical Works¡¨. This report summarises the monitoring results and audit findings of the EM&A programme under the issued EP No. EP-457/2013/D, and in accordance with the EM&A programme in the Ho Man Tin area during the reporting period from 1 August 2025 ¡V 31 August 2025.
2. The major site activities undertaken in the reporting month included:
Environmental
Monitoring Works
3. Environmental monitoring for the Project was performed in accordance with the EM&A Manual, and the monitoring results were checked and reviewed. Joint weekly site inspections with the representative of ET, the Engineer Representative and the Contractor for Contract No. HY/2019/13 were conducted on 6, 12, 19 & 26 August 2025, whereas a joint site inspection with the representative of IEC was conducted on 12 August 2025. The implementation of the environmental mitigation measures, Event and Action Plans and environmental complaint handling procedures was also checked.
4.
A summary of the non-compliance (exceedance) during the reporting month (August 2025) and the investigation results and/or follow-up actions
is provided below:
Complaint Handling, Prosecution and Public Engagement
5.
Summary of complaint/summons/prosecution in the
reporting month is tabulated in Table I.
Event |
Event Details |
Follow-up/ Remedial Actions |
Status/ Remarks |
|
Number |
Brief Description |
|||
Complaints Received |
1 |
A complaint was received from 1823 on 11
August 2025 regarding a noise nuisance from the Ho Man Tin site at 2:00 am
and 7:00 am that impacts the nearby residents. |
There is no site work during the complaint period.
The complaint was considered as non-project-related. |
The Complaint Investigation was completed and the
report was finalised on 28 Aug 2025. The complainant and
EPD have no further comment. |
Notification of Summons and
Prosecutions Received |
0 |
- |
- |
- |
Reporting Changes
6. There were no reporting changes during the reporting month.
Future Key Issues
7. The key works or activities will be anticipated in the coming two months are as follows:
Party |
Role |
Contact Person |
Phone No. |
AMMJV |
Engineer
Representative |
Mr.
Tommy Wong |
3695 0419 |
Cinotech |
Environmental
Team |
Ms.
Betty Choi |
2151 2072 |
ERM |
Independent
Environmental Checker |
Ms.
Mandy To |
2271 3113 |
GCL |
Contractor |
Mr.
William Chan |
5408 3045 |
Permit / License No. |
Valid Period |
Status |
|
From |
To |
||
Environmental Permit (EP) |
|||
EP-457/2013/D |
15
Jun 2021 |
N/A |
Valid |
Notification of Construction Works under
Air Pollution Control Ordinance (APCO) |
|||
457345 |
19
Jun 2020 |
End
of Project |
Valid |
Billing Account for Construction Waste
Disposal |
|||
7037679 |
26
Jun 2020 |
N/A |
Valid |
Registration of Chemical Waste Producer ¡V
Ho Man Tin |
|||
5213-236-G2347-61 |
28
Nov 2023 |
N/A |
Valid |
Wastewater Discharge Licence - Ho Man Tin |
|||
WT10002215-2023 |
2
Feb 2024 |
31
Jan 2029 |
Valid |
Construction Noise Permit - Ho Man Tin |
|||
GW-RE0352-25 |
14 Apr 2025 |
13 Oct 2025 |
Valid |
Monitoring Stations |
Locations |
Location of Measurement |
M-A3 |
S.K.H. Tsoi Kung Po
Secondary School |
Rooftop
(above 3/F) Area |
Equipment |
Model and Make |
Serial No. |
Quantity |
Calibrator |
TISCH TE-5025A |
3864 |
1 |
1-hour TSP Dust Meter |
Dust Monitor System OC-9200 |
OC20210316224101 |
1 |
High Volume Sampler |
TE-5170 c/w of TSP sampling inlet |
2204 |
1 |
Wind Anemometer |
C-OC-9200-wind |
OC20210316224101 |
1 |
Parameters |
Frequency |
1-hour TSP |
Three times / 6 days |
24-hour TSP |
Once / 6 days |
Monitoring Stations |
Locations |
Location of Measurement |
M-N3 |
S.K.H. Tsoi Kung Po
Secondary School |
Rooftop
(above 3/F) Area |
Equipment |
Model and Make |
Serial No. |
Quantity |
Sound Calibrator |
Hangzhou Aihua Instruments Co., Ltd. AWA6021A |
1023064 |
1 |
Integrating Sound Level Meter |
BSWA Technology BSWA 308 |
570188, 580238 |
2 |
Monitoring Stations |
Parameter |
Period |
Frequency |
Measurement |
M-N3 |
L10(30 min.) dB(A) L90(30 min.) dB(A) Leq(30 min.) dB(A) |
0700-1900 hrs on normal weekdays |
Once per week |
Façade |
Monitoring
Stations |
Baseline Noise Level, dB (A) |
Noise
Limit Level, dB (A) |
M-N3 |
67.7(1) (at 0700 ¡V
1900 hrs on normal weekdays) |
70(*) (at 0700 ¡V
1900 hrs on normal weekdays) |
(*) Noise Limit Level is 65 dB(A) during school
examination periods.
Note (1): The noise level due to the construction
work (CNL) was calculated by the following formula:
CNL = 10 log
(10MNL/10 ¡V 10BNL/10)
Remarks:
MNL = Measured Noise Level, BNL = Baseline Noise Level
Quantity |
|||||||
|
Inert C&D Materials |
Non-inert C&D Materials |
|||||
Reporting
Period |
Total
Quantity Generated (in
'000m3) |
Disposed
as Public
Fill (in '000m3) |
Others,
e.g. general
refuse (in '000m3) |
Metals (in
'000kg) |
Paper/cardboard Packaging (in
'000kg) |
Plastics (in
'000kg) |
Chemical
waste (in '000kg) |
August 2025 |
0.122 |
0.122 |
0.097 |
0 |
0 |
0 |
0 |
Parameters |
Date |
Observations |
Follow-up
Actions |
Water Quality |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Air Quality |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Noise |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Waste / Chemical
Management |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Land
Contamination |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Landscape and Visual |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
Permits /Licences |
N/A |
No environmental deficiency was identified in the
reporting period. |
N/A |
EP Condition (EP-457/2013/D) |
Submission |
Submission Date |
Condition
3.4 |
Monthly
EM&A Report (July
2025) |
12 August 2025 |

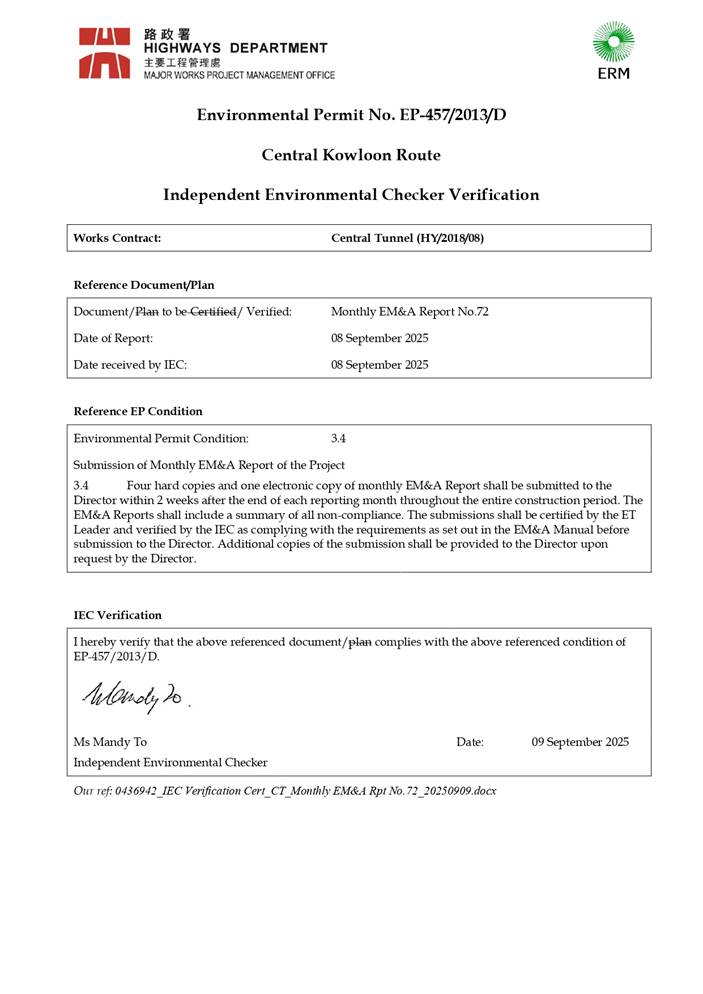

I. Introduction

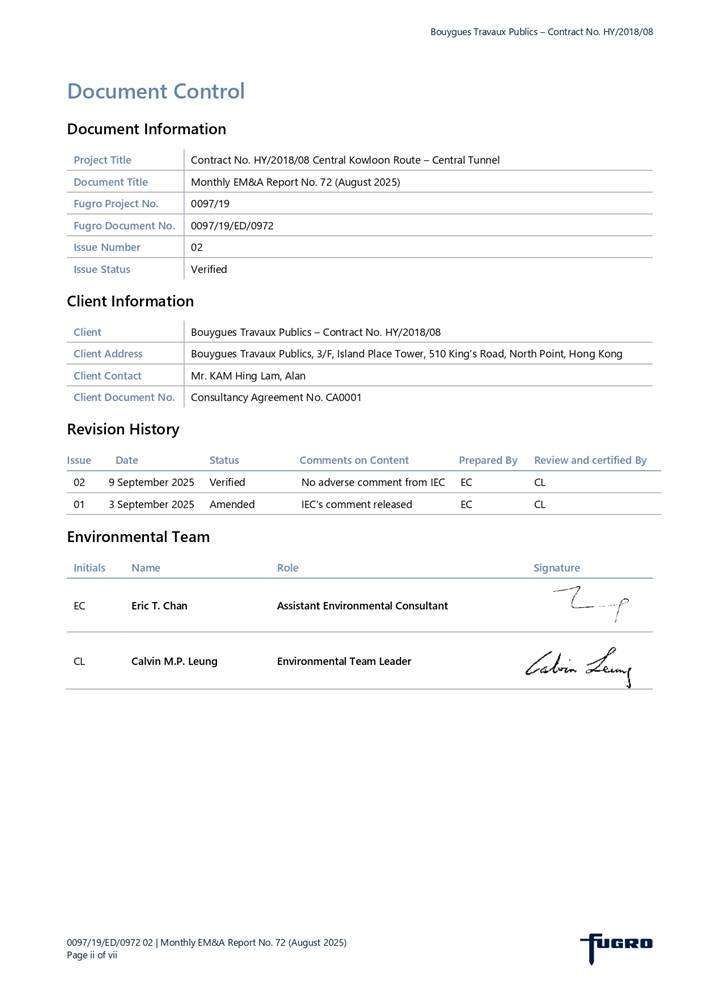

This is the 72nd Monthly EM&A Report prepared by
Fugro Technical Services Limited for the Contract No. HY/2018/08 Central
Kowloon Route ¡V Central Tunnel. The Contract No. HY/2018/08 commenced on 19
September 2019. This report summarized the monitoring results and audits
findings of the EM&A programme under the issued EP (EP No.: EP-457/2013/D)
and in accordance with the EM&A Manual during the reporting period from
01/08/2025 to 31/08/2025.
II. Summary of Main Works Undertaken and Key Measures Implemented
The main construction works carried out in the reporting period were as
follow:
Ma
Tau Kok
¡P Plant and material lifting;
¡P Cut and cover construction.
III. Summary of Exceedances, Investigation and Follow-up
The last impact monitoring conducted by ET of Contract HY/2018/08 at
M-A3/ M-N3 was on 27 December 2023. Impact monitoring at M-A3/ M-N3 was
subsequently conducted by Environmental Team of Contract No. HY/2019/13 since
January 2024. The monitoring results at M-A3 and M-N3 are presented in the
monthly EM&A Report prepared by Contract No. HY/2019/13.
No Action and Limit Level exceedance was recorded for construction dust
monitoring in the reporting month.
No Action and Limit Level exceedance was recorded for construction noise
monitoring in the reporting month.
IV. Complaint Handling, Prosecution and Public Engagement.
No
complaints were received in the reporting month.
The complaint cases in August 2025 are summarized in Table I.
Table I Environmental
Complaints Log
Complaint Log No. |
Date of Complaint |
Received From |
Nature of Complaint |
Status |
Nil |
Nil |
Nil |
Nil |
No notification of summons and prosecutions were received in the
reporting period.
No public engagement activities were conducted in the reporting period.
V. Reporting Change
As informed by the Contractor and the Engineer¡¦s Representative (ER) in
the Site Safety and Environmental Management Committee (SSEMC) Meeting on 28
August 2025, the EM&A Programme of Contract No. HY/2018/08 was terminated
on 31 August 2025.
This Monthly EM&A Report (August 2025) would be the last Monthly
EM&A Report of Contract No. HY/2018/08.
VI. Future Key Issues
According to the Contractor, all major construction works have been completed and
the Ma Tau Kok Construction Site was handed over to Contract No. HY/2014/07 on
29 July 2025. Therefore, no significant environmental impact was expected and
thus no mitigation measures were recommended.
The following EP submissions were submitted during the reporting month:
Table II Status of
Required Submission under Environmental Permit
EP Condition |
Submission |
Submission Date |
3.4 |
Monthly EM&A
Report (July 2025) |
7 August 2025 |
Contents
1.3 Construction Programme and Activities
1.4 Works undertaken during the month
1.5 Status of Environmental Licences, Notification and
Permits
2 ENVIRONMENTAL
MONITORING REQUIREMENTS
2.1 Construction Dust and Noise
Monitoring Locations
2.2 Construction Dust Monitoring
2.3 Construction Noise Monitoring
3 ENVIRONMENTAL
MONITORING RESULTS
3.1 Construction Dust Monitoring
3.2 Construction Noise Monitoring
5 ENVIRONMENTAL COMPLAINT
AND NON-COMPLIANCE
5.1 Complaint Handling,
Prosecution and Public Engagement
5.2 Summary of Environmental
Non-Compliance
5.3 Summary of Monitoring
Exceedance
8 CONCLUSION AND
RECOMMENDATIONS
Tables
Table
I ¡V Environmental Complaints Log
Table
II ¡V Status of Required Submission under Environmental Permit
Table 1.1
¡V Contact Information of Key Personnel
Table 1.2
¡V Environmental Licenses, Notification and Permits Summary
Table 2.1
¡V Construction Dust and Noise Monitoring Location
Table 2.2
¡V Construction Noise Monitoring Parameters, Frequency and Duration
Table 4.1
¡V Observations and Recommendation of Site Inspection in the Reporting Period
Table 5.1
¡V Environmental Complaints Log
Table 6.1
¡V Status of Required Submission under Environmental Permit
Figures
Figure 1 The Site Layout Plan of
the Contract
Figure 2.1 The Location of the Construction Dust and Noise Monitoring Stations (Ho
Man Tin)
Figure 2.2 The Location of the Construction Dust and Noise Monitoring Stations (Ma
Tau Kok)
Figure 2.3 The Location of the Construction Dust and Noise Monitoring Stations (Yau
Ma Tei)
Appendices
Appendix A Construction Programme
Appendix B Project Organization Chart
Appendix C Event and Action Plan
Appendix D Implementation Status of Environment Mitigation Measures
(Construction Phase)
1.1.1 In order to meet the traffic demand and relieve traffic congestion on the
existing east-west roads across Central Kowloon, Central Kowloon Route (CKR)
(hereinafter referred to as ¡§the Project¡¨) is proposed which is a 4.7 km long
dual 3-lane trunk road in Central Kowloon linking Yau Ma Tei Interchange in
West Kowloon with the road network on Kai Tak Development and Kowloon Bay in
East Kowloon.
1.1.2 The Central Kowloon Route ¡V Design and Construction Environmental Impact
Assessment Report (Register No.: AEIAR-171/2013) was approved with conditions
by the Environmental Protection Department (EPD) on 11 July 2013. An
Environmental Permit (EP-457/2013) was issued on 9 August 2013. A variation of
EP (VEP-594/2021) was applied on 26 May 2021 and the latest EP (EP-457/2013/D)
was issued by EPD on 15 June 2021.
1.1.3 Contract No. HY/2018/08 Central Kowloon Route ¡V Central Tunnel
(hereinafter referred to as ¡§the Contract¡¨), is one of the contracts of CKR
which included the construction of the central tunnel, cut-and-cover tunnels at
Yau Ma Tei and Ma Tau Kok and construction of piles and diaphragm walls for Ho
Man Tin ventilation building.
1.1.4 Fugro Technical Services Limited (FTS) was appointed by Bouygues Travaux
Publics (BTP) as the Environmental Team (ET) under the Contract no. HY/2018/08
to execute the environmental monitoring and audit (EM&A) programme under
the issued EP (EP No.: EP-457/2013/D) and in accordance with the EM&A
Manual.
1.1.5 This is the 72nd Monthly EM&A Report prepared by FTS
for the Contract No. HY/2018/08 Central Kowloon Route ¡V Central Tunnel. The
Contract No. HY/2018/08 commenced on 19 September 2019. This report summarized
the monitoring results and audits findings of the EM&A programme under the
issued EP (EP No.: EP-457/2013/D) and in accordance with the EM&A Manual
during the reporting period from 01/08/2025 to 31/08/2025.
1.2.1 The Project Organization structure is shown in Appendix B.
The key personnel contact names and numbers are summarized in Table 1.1.
Table 1.1 Contact
Information of Key Personnel
Party |
Position |
Name |
Telephone |
Highways Department (HyD) |
E13/CKR |
Mr. Joe Lam |
2762 3380 |
Arup-Mott MacDonald Joint Venture (AMMJV) |
Senior Resident Engineer |
Mr. Ben Poon |
3619 5967 |
ERM-Hong Kong, Limited (ERM) |
Independent Environmental Checker (IEC) |
Ms. Mandy To |
2271 3000 |
Bouygues Travaux Publics (BTP) |
Environmental Manager |
Mr.
Simon Wong |
9281
4346 |
Fugro Technical Services Limited |
ET Leader |
Mr. Calvin Leung |
3565 4441 |
1.3 Construction
Programme and Activities
1.3.1 The construction phase of this Contract under the EP commenced in October
2019. The site layout plan of the Contract is shown in Figure 1.
1.3.2 The construction programme of this Contract is shown in Appendix
A.
1.4 Works undertaken
during the month
1.4.1 The main construction works carried out in the reporting period were as
follow:
¡P Plant and material lifting;
¡P Cut and cover construction.
1.5 Status of
Environmental Licences, Notification and Permits
1.5.1 A summary of the relevant permits, licenses and/or notifications on
environmental protection for this Contract is presented in Table 1.2.
Table 1.2 Environmental
Licenses, Notification and Permits Summary
Reference No |
Valid From |
Valid Till |
|
Form NB |
448930, 448970, 448971 |
Mid-Sep 2019 |
NA |
Billing Account for
Disposal of C&D waste |
Account no. 7034790 |
06 Aug 2019 |
NA |
Chemical Waste Producer
Registration (Ho Man Tin Construction site) |
5111-236-B2557-02 |
25 Sep 2019 |
NA |
Chemical Waste Producer
Registration (Yau Ma Tei Construction site) |
5213-225-B2557-05 |
19 Apr 2021 |
NA |
Chemical Waste Producer
Registration (Ma Tau Kok Construction site) |
5213-247-B2557-06 |
19 Apr 2021 |
NA |
Construction Noise
Permit |
|||
Construction Noise
Permit (Ma Tau Kok Construction site) |
GW-RE0207-25 |
8 Mar 2025 |
31 Aug 2025 |
Water Discharge
License |
|||
|
WT00037723-2021 (Yau Ma Tei Construction site) |
07 Apr 2021 |
30 Apr 2026 |
WT00037883-2021 (Ma Tau Kok Construction site) |
30 Apr 2021 |
30 Apr 2026 |
|
WT00042304-2022 (Sheung Lok Street) |
13 Oct 2022 |
31 Oct 2027 |
|
WT10001427-20233 (Ma Hang Chung Road) |
4 Dec 2023 |
31 Dec 2028 |
|
WT00041154-2022 (Kai Tak Barging Facility) |
12 Jul 2022 |
31 Jul 2027 |
2 ENVIRONMENTAL MONITORING REQUIREMENTS
2.1 Construction Dust and Noise Monitoring Locations
2.1.1 Three construction dust monitoring locations and five construction noise
monitoring locations pertinent to the Project have been identified based on the
approved EM&A Manual for the Project. The locations of the construction
dust and noise monitoring stations are summarized in Table 2.1 as
displayed in Figures 2.1 - 2.3.
Table 2.1 Construction
Dust and Noise Monitoring Locations
Dust Monitoring Station ID |
Noise Monitoring Station ID |
Monitoring Location |
M-A3 |
M-N3 |
SKH Tsoi Kung Po Secondary
School |
/ |
E-N12a |
19 Hing Yan Street |
E-A14a |
E-N21a |
Block B of Merit Industrial
Centre |
W-A6 |
/ |
Man Cheong building |
/ |
W-N18 |
Hydan Place |
/ |
W-N25A |
Prosperous Garden Block 1 |
Notes:
1. The dust and noise
monitoring stations proposed in the EM&A Manual for M-A6/ M-N6 (i.e. Ko Fai House, Kwun
Fai Court) was not available for impact dust and noise monitoring, therefore
impact monitoring was conducted at M-A3/ M-N3 as an alternative which was
agreed by the ER, IEC and EPD;
2. The noise monitoring
station proposed in the EM&A Manual for E-N12 (i.e. Grand Waterfront Tower
3) was not available for impact dust and noise monitoring, therefore impact
monitoring was conducted at E-N12a as an alternative which was agreed by the
ER, IEC and EPD;
3. The dust and noise
monitoring stations proposed in the EM&A Manual for E-A14 (i.e. Wyler
Gardens) and
E-N21 (i.e Hang Chien Court Block J) was not
available for impact dust and noise monitoring, therefore impact monitoring was
conducted at E-A14a/ E-N21a as an alternative which was agreed by the ER, IEC
and EPD;
4. The dust monitoring
stations proposed in the EM&A Manual for W-A5 (i.e. The Coronation) was not
available for impact dust monitoring, therefore impact monitoring was conducted
at W-A6 as an alternative which was agreed by the ER, IEC and EPD.
2.1.2 The last impact monitoring conducted by ET of Contract HY/2018/08 at
M-A3/ M-N3 was on 27 December 2023. Impact monitoring at M-A3/ M-N3 was
subsequently conducted by Environmental Team of Contract HY/2019/13 since
January 2024 (Figure 2.1).
2.1.3 The construction dust and noise monitoring locations at M-A3 and M-N3 are
covered by Contract No. HY/2019/13 Central Kowloon Route ¡V Buildings,
Electrical and Mechanical Works. The monitoring results at M-A3 and M-N3 are
presented in the monthly EM&A Report prepared by Contract No. HY/2019/13.
2.1.4 The construction dust and noise monitoring locations at E-A14a, E-N12a
and E-N21a are now covered by Contract No. HY/2014/07 Central Kowloon Route ¡V
Kai Tak West. The monitoring results at E-A14a, E-N12a and E-N21a in the
reporting month are presented in the monthly EM&A Report prepared by
Contract No. HY/2014/07.
2.1.5 The construction dust and noise monitoring locations at W-A6, W-N18 and
W-N25A are now covered by Contract No. HY/2014/08 Central Kowloon Route ¡VYau Ma
Tei East. The monitoring results at W-A6, W-N18 and W-N25A in the reporting
month are presented in the monthly EM&A Report prepared by Contract No.
HY/2014/08.
2.2 Construction Dust Monitoring
Monitoring
Requirement
2.2.1 In accordance with the approved EM&A Manual, 1-hour and 24-hour Total
Suspended Particulates (TSP) levels should be measured at the designated air
quality monitoring stations to indicate the impacts of construction dust on air
quality. Regular Impact 24-hour TSP monitoring should be carried out for at
least once every 6 days, and 1-hour TSP monitoring should be done at least 3
times every 6 days when the highest dust impact occurs.
Monitoring
Equipment
2.2.2 24-hour TSP air quality monitoring was performed using High Volume
Sampler (HVS) deployed at the designated monitoring station. The HVS shall meet
all the requirements of the EM&A Manual.
2.2.3 A portable direct reading dust meter was used to carry out the 1-hour TSP
monitoring.
2.3 Construction Noise Monitoring
Monitoring
Requirement
2.3.1 In accordance with the EM&A Manual, impact noise monitoring should be
conducted at the designated noise monitoring stations for at least once a week
during the construction phase of the Project. The parameters, frequency and
duration of impact noise monitoring is summarized in Table 2.2.
Table 2.2 Construction
Noise Monitoring Parameters, Frequency and Duration
Parameter |
Duration |
Frequency |
A-weighted equivalent
continuous sound pressure level (Leq). L10 and L90
were also recorded |
30 minutes |
At least once per week |
Monitoring
Equipment
2.3.2 Noise monitoring was performed using sound level meter at the designated
monitoring station. The sound level meters deployed comply with the
International Electrotechnical Commission Publications 651:1979 (Type 1) and
804:1985 (Type 1) specifications. Acoustic calibrator was deployed to check the
sound level meters at a known sound pressure level.
2.4.1 As per the EM&A Manual, the landscape and visual mitigation measures
shall be implemented and site inspections should be undertaken once
every two weeks during the construction period. A summary of the implementation
status is presented in Section 4.
3 ENVIRONMENTAL MONITORING RESULTS
3.1 Construction Dust Monitoring
3.1.1 The last impact monitoring conducted by ET of Contract HY/2018/08 was on
27 December 2023. Impact monitoring at M-A3 was subsequently conducted by
Environmental Team of Contract HY/2019/13 since January 2024. The monitoring
results at M-A3 and M-N3 are presented in the monthly EM&A Report prepared
by Contract No. HY/2019/13.
3.1.2 No Action and Limit Level exceedance was recorded for construction dust
monitoring in the reporting month.
3.2 Construction Noise Monitoring
3.2.1 The last impact monitoring conducted by ET of Contract HY/2018/08 was on
27 December 2023. Impact monitoring at M-N3 was subsequently conducted by
Environmental Team of Contract HY/2019/13 since January 2024. The monitoring
results at M-A3 and M-N3 are presented in the monthly EM&A Report prepared
by Contract No. HY/2019/13.
3.2.2 No Action and Limit Level exceedance was recorded for construction noise
monitoring in the reporting month.
3.3.1 Auditing of waste management practices during regular site inspections
confirmed that the waste generated during construction were properly, stored,
handled and disposed of in general. The Contractor was responsible for the implementation of any mitigation
measures to reduce waste or redress issues arising from the waste materials.
3.3.2 The implemented environmental mitigation measures for the waste
management in the reporting period are summarized in Appendix D.
The summary of observations and recommendations made for waste management
during the site inspections are presented in Table 4.1.
3.3.3 Monthly summary of waste flow table is detailed in Appendix F.
3.4.1 Bi-weekly inspections of the implementation of landscape and visual
mitigation measures were conducted on 12 and 28 August 2025. The implementation
the landscape and visual mitigation measures in the reporting period are
summarized in Appendix D. The summary of observations and
recommendations made for landscape and visual mitigation measures during the
site inspections are presented in Table 4.1.
3.4.2 The Event and Action Plan for landscape and visual during construction
phase is given in Appendix C.
4 ENVIRONMENTAL SITE INSPECTION AND AUDIT
4.1.1 Site inspections were carried out on a weekly basis to monitor the
implementation of proper environmental pollution control and mitigation
measures for the Project. A summary of the mitigation measures implementation
status is provided in Appendix D.
4.1.2 In the reporting month, four site inspections were carried out on 6, 12,
19 and 28 (with IEC) August 2025. Details of observations recorded during the
site inspections are presented in Table 4.1.
Table 4.1 Observations
and Recommendation of Site Inspection in the Reporting Period
Environmental Aspect |
Date |
Observations,
Reminders, and Recommendations |
Follow-up Actions |
Air Quality |
Nil |
Nil |
Nil |
Noise |
Nil |
Nil |
Nil |
Water Quality |
Nil |
Nil |
Nil |
Waste Management |
Nil |
Nil |
Nil |
Landscape and Visual |
Nil |
Nil |
Nil |
Permit/ Licenses |
Nil |
Nil |
Nil |
5 ENVIRONMENTAL COMPLAINT AND NON-COMPLIANCE
5.1 Complaint Handling, Prosecution and Public Engagement
5.1.1 No complaints were received in the reporting month.
5.1.2 The complaint cases in August 2025 are summarized in Table 5.1.
Table 5.1 Environmental
Complaints Log
Complaint Log No. |
Date of Complaint |
Received From |
Nature of Complaint |
Status |
Nil |
Nil |
Nil |
Nil |
Nil |
5.1.3 Cumulative complaint log, summaries of complaints, notification of
summons and successful prosecutions are presented in Appendix E.
5.1.4 No public engagement activities were conducted in the reporting period.
5.2 Summary of Environmental Non-Compliance
5.2.1 No environmental non-compliance was recorded in the reporting period.
5.3 Summary of Monitoring Exceedance
5.3.1 The last impact monitoring conducted by ET of Contract HY/2018/08 at
M-A3/ M-N3 was on 27 December 2023. Impact monitoring at M-A3/ M-N3 was
subsequently conducted by Environmental Team of Contract HY/2019/13 since
January 2024. The monitoring results at M-A3 and
M-N3 are presented in the monthly EM&A Report prepared by Contract No.
HY/2019/13.
5.3.2 No Action and Limit Level exceedance was recorded for construction dust
monitoring in the reporting month.
5.3.3 No Action and Limit Level exceedance was recorded for construction noise
monitoring in the reporting month.
6 IMPLEMENTATION STATUS OF ENVIRONMENTAL MITIGATION
MEASURE
6.1.1 The Contractor had implemented environmental mitigation measures and
requirements as stated in the EIA Report, the EP and EM&A Manual. The
implementation status of the environmental mitigation measures during the
reporting period is summarized in Appendix D. Status of required
submissions under the EP during the reporting period is summarised in Table
6.1.
Table 6.1 Status
of Required Submission under Environmental Permit
EP Condition |
Submission |
Submission Date |
3.4 |
Monthly EM&A
Report (July 2025) |
7 August 2025 |
7.1.1 Following the handover of the Ma Tau Kok Construction Site to
Contract No. HY/2014/07 on 29 July 2025, it is confirmed by the Contractor that
all the working areas were handed over to other working contracts of Central
Kowloon Route.
7.1.2 According to the Contractor, all major construction works have been
substantially completed and no significant environmental impact is
expected.
8 CONCLUSION AND RECOMMENDATIONS
8.1.1 The 72nd Monthly EM&A Report for the Contract No.
HY/2018/08 Central Kowloon Route ¡V Central Tunnel summarized the monitoring
results and audits findings of the EM&A programme under the issued EP (EP
No.: EP-457/2013/D) and in accordance with the EM&A Manual during the
reporting period from 01/08/2025 to 31/08/2025.
8.1.2 No construction noise monitoring was conducted in the reporting month as
the site had been handed over to Contract No. HY/2019/13 on 30 December 2023.
Impact monitoring at M-A3/ M-N3 has been conducted by Environmental Team
(HY/2019/13) since January 2024.
8.1.3 No Action and Limit Level exceedance was recorded for construction noise
monitoring in the reporting month. No Action and Limit Level exceedance was
recorded for construction dust monitoring in the reporting month.
8.1.4 Weekly environmental site inspections were conducted during the reporting
period. In general, the Contractor had implemented environmental mitigation
measures and requirements as stated in the EIA Report, the EP and EM&A
Manual.
8.1.5 No complaints were received in the reporting month.
8.1.6 No environmental related prosecutions or notification of summons were
received in the reporting period.
8.1.7 No environmental non-compliance was recorded in the reporting period.
8.1.8 According to the environmental site inspections performed in the
reporting month, the following recommendations were provided:
Air
Quality Impact
¡P No specific observation was
identified in the reporting month.
Construction
Noise Impact
¡P No specific observation was
identified in the reporting month.
Water
Quality Impact
¡P No specific observation was
identified in the reporting month.
Waste
Management
¡P No specific observation was
identified in the reporting month.
Landscape
and Visual Impact
¡P No specific observation was
identified in the reporting month.
Permit/
Licenses
¡P No specific observation was
identified in the reporting month.
8.1.9 As informed by the Contractor and the Engineer¡¦s Representative in the
Site Safety and Environmental Management Committee (SSEMC) Meeting on 28 August
2025, the EM&A Programme of Contract No. HY/2018/08 was terminated on 31
August 2025.
8.1.10 This Monthly EM&A Report (August 2025) would be the last Monthly
EM&A Report of Contract No. HY/2018/08.
